Every IT project has a risk register. Almost none are read after week three, because the rows describe conditions ("integration may be delayed") rather than decisions someone has to make by a date. A register that gets read has six things on every row: a cause-and-effect statement, a trigger you can observe, an owner, the cost of doing nothing for a week, a decision date, and the options on the table when that date arrives. It is reviewed in the same meeting as the schedule, not in a separate ritual. PMI's 2026 Pulse of the Profession found that 31% of complex projects fail to achieve the full scope of their intended benefits, more than twice the 12% rate for projects overall. This guide covers the six columns, the three categories of risk IT projects under-record, how the register changes across delivery methodologies, and a review rhythm that keeps it alive.
I have opened a lot of risk registers in month five of a project. The pattern is consistent. Forty rows, written in the first two weeks, scored red-amber-green, last updated the week the PMO asked for it. Half the rows have already happened. The other half describe things that were never going to happen, and the risk that is currently sinking the project is not on the list.
Nobody was lazy. The register was built to satisfy a template, and the template asks for conditions and scores. It does not ask what anyone is supposed to do.
Risk management in IT projects is the practice of identifying what could prevent the project from delivering its intended benefits, deciding in advance what will be done about each one, and acting on those decisions before the risk becomes an issue. The register is where those decisions are recorded.
Registers stop being read for one reason: nothing in them requires anyone to do anything. A row that says "vendor may deliver late, likelihood medium, impact high, mitigation: monitor" is a description. It has no trigger, no date, and no decision. It can sit at amber for six months and be technically correct the whole time.
The scale of the problem is not small. PMI's 2026 Pulse of the Profession, drawing on 2,023 project professionals and 511 senior leaders across 35 countries, found that 31% of complex projects fail to achieve the full scope of their originally intended benefits, more than twice the 12% rate reported for projects overall in PMI's 2024 research.<sup>[1]</sup> The report attributes much of the gap to organizational rather than technical factors, and unowned decisions are the most organizational failure there is.
Most IT projects are complex projects by that report's definition. They have multiple systems, multiple stakeholder groups, and dependencies nobody fully mapped. The register is the document that is supposed to hold the plan for when those dependencies fail.
Key Takeaway: A risk register is a list of decisions with dates, or it is a list of worries with colours. Only the first kind changes anything.
Running a programme where the register was last updated at kickoff? Our Planning practice rebuilds it around decisions and dates. Book a free consultation.
Six columns. The first two are what most templates already have. The other four are what makes the row actionable.
The cost column is the one that gets the register opened. Executives do not read risk registers. They do read a line that says a specific decision, left for one more week, moves cutover by a month.
The decision date is the column that stops rows sitting at amber forever. A risk with a decision date is a milestone. It goes on the same calendar as the build tasks, it turns red when it passes, and someone has to explain why.
Most registers arrive with likelihood and impact scores and none of the other four columns, because the template came from a methodology handbook and the handbook was written for scoring, not deciding. ID Business Analysis Canada rebuilds the register as a deliverable of every Requirements Engagement on a delivery program, with a business analyst rewriting each row into the six-column form, tracing the trigger to something observable in the project's own systems or vendor commitments, and putting every decision date onto the delivery calendar next to the milestones it protects.
Key Takeaway: Six columns. If a row cannot state what the owner decides, by when, at what cost of waiting, it is a worry with a colour, and it should come off the register.

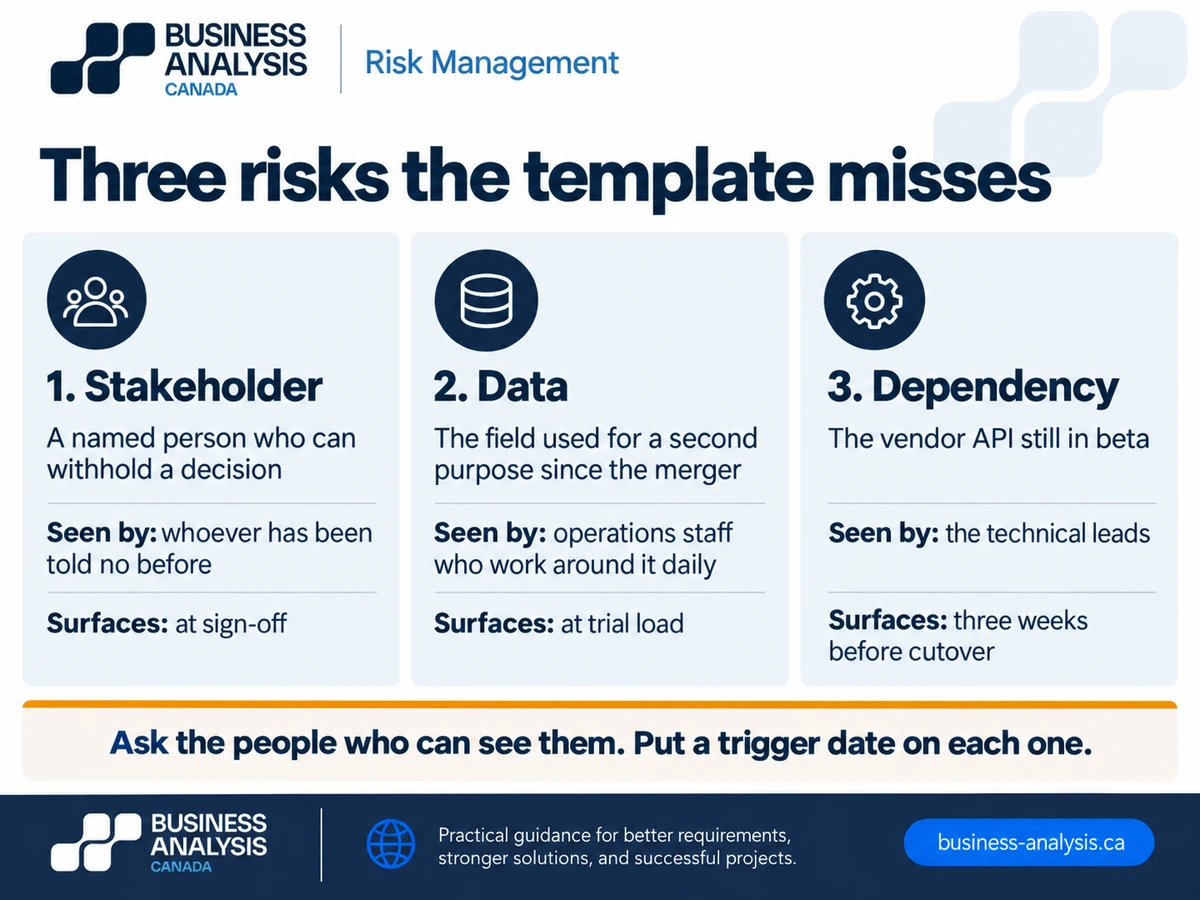

Three categories, and each is under-recorded for the same reason: the person who can see it is not the person writing the register.

Technical delivery risk, the category most registers are full of, is usually the best managed, because the developers see it and raise it. The three above are the ones that sink projects, and they are the ones a template-driven register misses.
Key Takeaway: Stakeholder, data, and dependency. Go and ask the people who can see them, and put a trigger date on each one.
The register changes shape, and the six columns do not.
Whichever methodology is in use, the review has to happen in the same meeting as the schedule. A risk review held separately from the schedule review is the ritual that produces month-five registers nobody has opened.
Key Takeaway: The methodology decides where the register lives and how often it is reviewed. The six columns are the same in all of them.

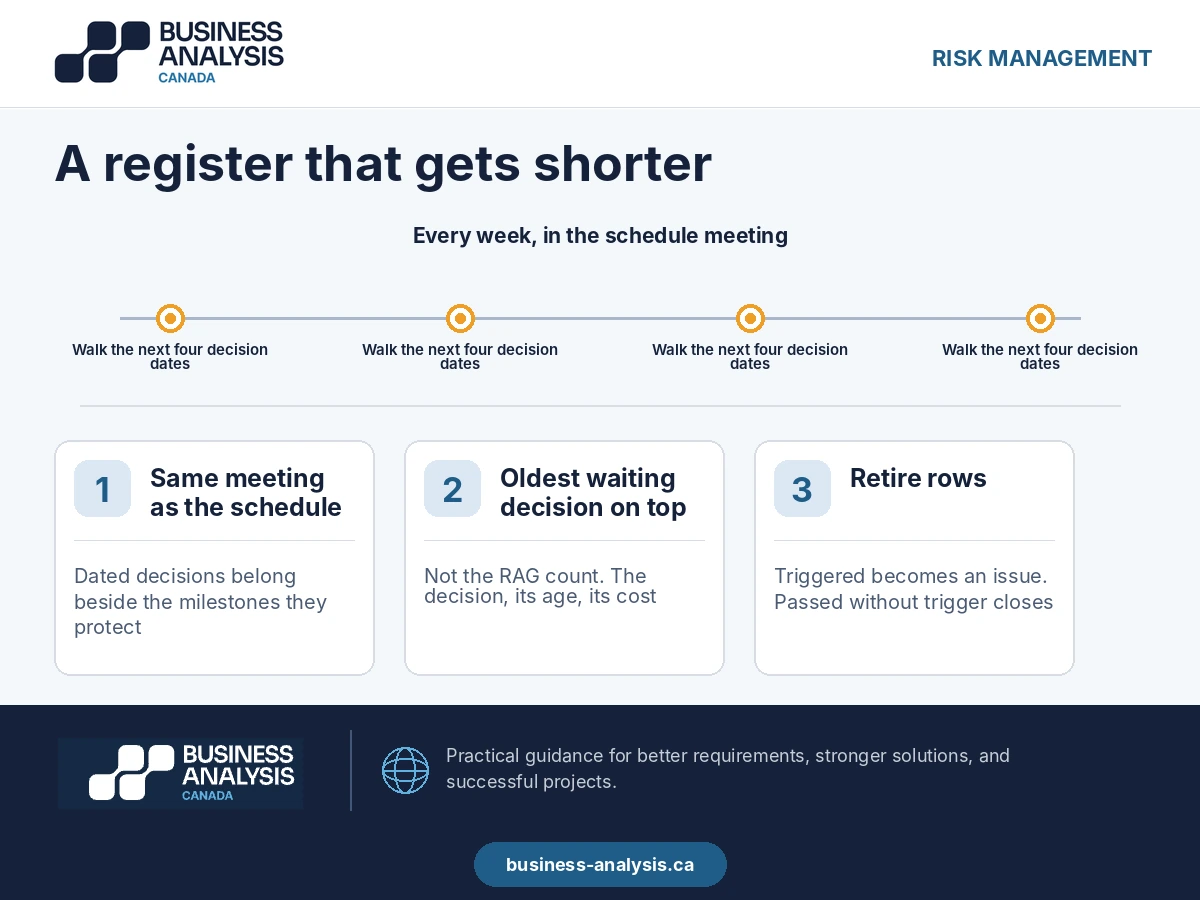

Three practices, all of which cost less than the review meeting most projects already hold.

The register should get shorter as the project progresses, because decisions are being made. A register that is longer in month six than in month one is recording worries faster than it is resolving them.
Key Takeaway: Same meeting as the schedule, oldest waiting decision at the top of the report, rows retired as decisions are made.
What is the difference between a risk and an issue in IT project management?A risk is something that may happen and has not yet; an issue is something that has happened and needs handling now. The transition between them is the trigger. When the trigger is observed, the risk row closes and an issue opens with the decision the owner already chose from the options column. Registers that mix the two become unreadable, because half the rows need a decision and half need action, and nothing distinguishes them.
How do we start rebuilding a risk register on a project that is already running?Take the current register and, for each row, ask whether it names a trigger, an owner, a cost of waiting, a decision date, and options. Rows that cannot be rewritten in that form come off. Then go to the three under-recorded categories, stakeholder, data, and dependency, and ask the people who can see them what they are worried about. ID Business Analysis Canada does this as a two-week rebuild inside a live program, with a business analyst producing the six-column register, the decision dates on the delivery calendar, and the first status report with the oldest waiting decision at the top. The rebuilt register is usually a third the length of the original.
How often should an IT project risk register be reviewed?As often as the schedule is reviewed, and in the same meeting, which on most programmes means weekly. The review itself is short if the register is in the six-column form: walk the decision dates falling in the next four weeks, confirm with each owner whether the trigger has appeared, and record the decision if the date has arrived. A monthly standalone risk review is the cadence that lets a decision date slip by three weeks before anyone sees it.
Is stakeholder management risk part of the project risk register?It should be, and it usually is not. Most registers hold technical and schedule risks in detail and stakeholder risk as one line. Each stakeholder who can withhold a decision is a risk row in its own right: a named person, the condition under which they withhold, the cost if they do, and the date by which their decision is needed. Moving those rows into the main register, with the same owner and review rhythm as everything else, is the single change that most improves how stakeholder risk gets handled.
The template asked for likelihood and impact, so that is what the register has. What the project needed was a list of decisions, each with a date and a cost of waiting, reviewed in the meeting where the schedule already is.
If your register was last opened when the PMO asked for it, ID Business Analysis Canada's Planning practice rebuilds it in the six-column form, puts the decision dates on the delivery calendar, and hands back a document a third the length that the steering committee will read. Book a free consultation and bring the current version.
